Investment opportunity · Dominican Republic · Phase I
A co-financed PPP in Santo Domingo and Punta Cana: 15.0 % equity IRR
A concession for elevated electric transport of people and light cargo: 73.1 km and 83 stations above the traffic, in a country that moves almost everything by road today.
Projections, not guarantees. Costs are ranges until suppliers quote. Official data carry their source.
The investment on one page
A private ticket of US$ 245 M in a 73.1 km concession with a 15.0 % equity IRR, a minimum DSCR of 1.64 and first service around April 2031.
What the investor is offered
- Co-financed PPP (the State funds part of the line works), for 40 years under Law 47-20 on Public-Private Partnerships. The State funds 55.1 % of the line works and contributes the land, and holds 20 % of the company; the concessionaire finances the rest, contracts the works, operates and collects the revenue.
- Equity IRR of 15.0 % (target: 15 %), project IRR of 8.0 %, minimum DSCR of 1.64 and equity payback in 7.2 years from first service.
- Revenue from fares, light cargo and parcels, land and shops, fibre and 5G on the towers, advertising, bookings and tourism bundles.
What gets built
- Santo Domingo (Ciudad Colonial – Los Héroes) and Punta Cana – Bávaro: 2 lines, 73.1 km and 83 stations, 3 of them megastations.
- Electric carriages on large fixed steel ropes: the chassis with the motors on top; below it, as a separate unit, a 9-seat cabin or a cargo box of up to 2.5 t.
- Passengers who book in the app do not wait at the station; walk-in passengers wait under 10 minutes at the 95th percentile.
A large market that moves by road today
People, freight and tourists depend on the road: a dedicated electric line above the traffic serves a market that already exists and keeps growing.
Passengers
A US$ 127.9 billion economy (BCRD Cuentas Nacionales, 2025) travels by guagua minibus, shared taxi, motorcycle taxi and car: 3.8 million motorcycles out of 6.6 million registered vehicles (DGII, Informe Parque Vehicular 2025).
Freight and ports
Caucedo alone handled 1.76 million TEU (DP World press release 26 Feb 2026, 2025). Parcels, e-commerce and waste travel in 2.5 t boxes on the elevated line, with no trucks in the city.
Tourism
Tourists who arrive by air continue to their hotel by road. A dedicated line between airports, resorts and cities serves a market that already pays for the transfer.
Sources: ONE, X Censo Nacional de Población y Vivienda 2022; INTRANT Encuesta Domiciliaria de Movilidad 2025-26, 2026; WHO Global Health Observatory RS_198, 2023; INTRANT OPSEVI, 2024; BCRD, Informe de la economía dominicana enero-diciembre 2025; BCRD Cuentas Nacionales, 2025; DP World press release 26 Feb 2026, 2025; DGII, Informe Parque Vehicular 2025; EMET/OPRET, 2026; Sistema Integrado de Transporte, 2026.

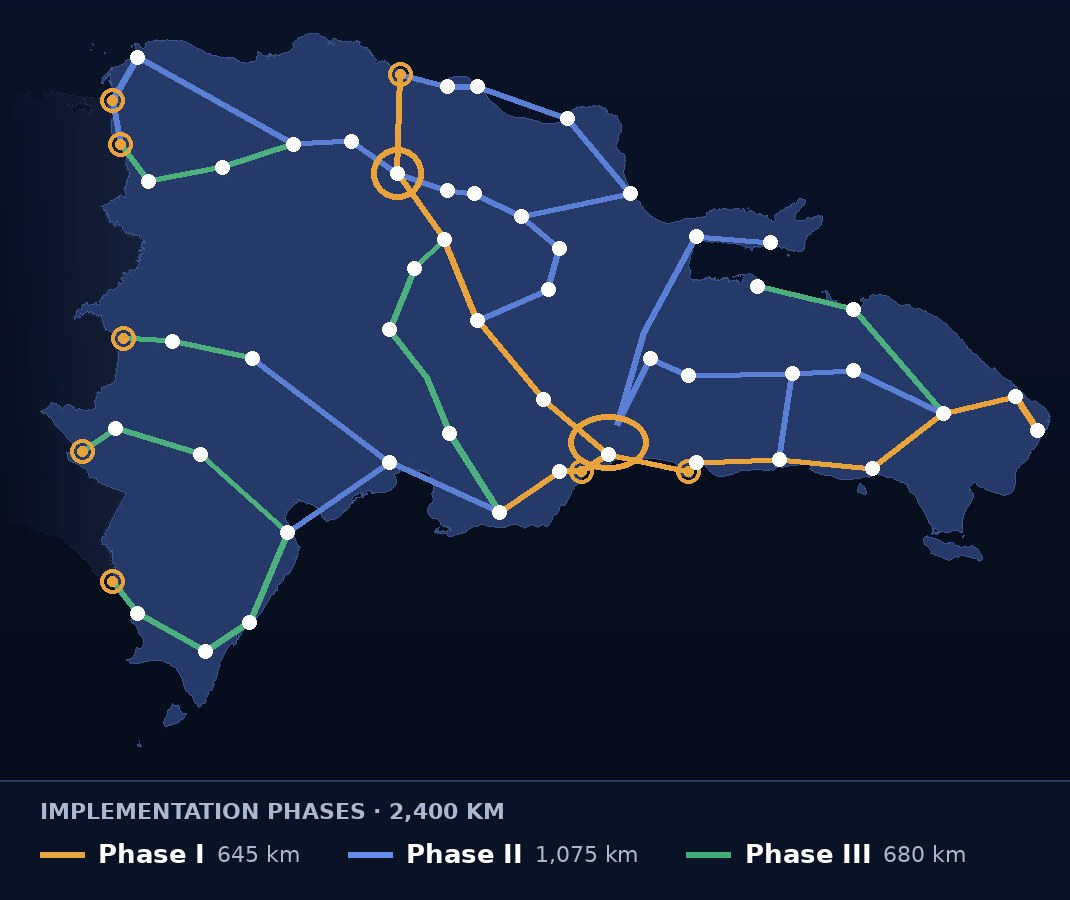

Phase I: 2 lines and 83 stations
A network of its own, above the traffic. Of the 9 packages studied, the chosen Phase I has the highest benefit-cost ratio.
Santo Domingo: Ciudad Colonial (Parque Independencia) – Los Héroes, 13.8 km and 29 stations; Punta Cana – Bávaro: Cap Cana – Arena Gorda – El Macao, 59.3 km and 54 stations.
How it works
The track
Each track has two large fixed steel ropes, carried by Celestavia towers about every 85 m. The carriage moves, not the rope.
Chassis on top, cabin below
The chassis rides on top, with the motors and the wheels on the ropes; below it hangs the 9-seat cabin or a cargo box of up to 2.5 t. They are separate units: at a small station the cabin is lowered to the ground and the chassis goes on.
The trip
Each cabin goes straight to its destination, with no stops on the way. Up to 90 km/h between cities and under 70 km/h in the city. The goal is zero accidents.
Phase I in 4 minutes
Santo Domingo and Punta Cana, above the traffic: how Celestavia works, the rush-hour race, the cost per kilometre against the alternatives, and how a trip works.
US$ 455 million: the central case
Phase I ranges from US$ 415 to 501 million (P10–P90), in 2026 US dollars, excluding ITBIS (VAT). It includes the engineering improvements (brakes, anchors, tower protection, 21-day tower batteries, evacuation and accessibility) and the active cabin suspension for trips over 30 minutes on Punta Cana – Bávaro, with their studies, permits and procurement: US$ 45.5 M (+11.1 % of the project grand total), spread over the items of the table.
| Component | US$ million (P10–P90) |
|---|---|
| Line: towers, foundations, ropes and crossings | 60–83 (P50 71) |
| 1.5 kV DC power: contact line, substations, connection and batteries | 62–84 (P50 72) |
| Small and key stations, access to the line | 60–97 (P50 76) |
| Megastations | 7–11 (P50 9) |
| Hurricane protection (tie-down yards) and workshops | 38–53 (P50 45) |
| Systems, operations and software | 32–47 (P50 39) |
| Opening fleet: carriages, cabins and cargo boxes | 77–94 (P50 85) |
| Studies, design, permits and fleet procurement | 46–67 (P50 56) |
| Phase I total | 415–501 (P50 455) |
| Section | Km | US$ million (P10–P90) | US$ M/km (P50) |
|---|---|---|---|
| Punta Cana – Bávaro | 59.3 | 235–290 (P50 261) | 4.4 |
| Santo Domingo | 13.8 | 156–186 (P50 170) | 12.3 |
| Phase | Km | US$ million |
|---|---|---|
| Phase I | 73.1 | 415–501 (P10–P90) |
| Phase II: the rest of SD1, SD2 and SD5 | 100.9 | 1,009 (P50) |
| Whole national network | 2,421 | 8,662–10,464 (P10–P90) |
Cost computed over 20,000 sets of unit prices; the cost per kilometre is computed in each set. Carriages and cabins priced as series automotive parts: about US$ 51 thousand per city carriage with its cabin (most likely values). Celestavia Co. designs and integrates the technology; towers, carriages, cabins and buildings are contracted to others.
Co-financed PPP: 15.0 % for the shareholder
Co-financed PPP (the State funds part of the line works), for 40 years. The State funds 55.1 % of the line works (US$ 211.9 M), contributes the land (US$ 18.2 M) and holds 20 % of the company. The concessionaire finances the rest, builds through contracts, operates and collects the revenue.
The State’s money
Co-financing of the works and the land add up to 45.8 % of the investment in present value. As an option, an availability payment of about US$ 26.2 M a year also reaches 15 % for the shareholder.
A benchmark for the State
The Santo Domingo section costs about US$ 12.3 M per kilometre (P50), with stations, power, systems and fleet. The first stage of the Santo Domingo Monorail was awarded for RD$ 28,986 million for 10.5 km (FITRAM, 2026): about US$ 45 M per kilometre at RD$ 61.52 to the dollar (BCRD, Informe de la economía dominicana enero-diciembre 2025).
Equity IRR by construction cost and demand
| Investment | 50 % of demand | 70 % of demand | 100 % of demand |
|---|---|---|---|
| P10 | 11.9 % | 22.5 % | 35.8 % |
| P50 | 9.7 % | 19.9 % | 32.6 % |
| P90 | 7.8 % | 17.3 % | 29.4 % |
Rows: investment at P10, P50 and P90. Columns: share of the traffic-study demand used in the model; the base case uses 60 %. Financing from multilateral and development banks, such as the IDB and the World Bank, and green bonds; private initiative filed with the Directorate General of Public-Private Partnerships (DGAPP).
Several revenue streams
In 2036 revenue reaches about US$ 68.8 M a year; 30 % comes from sources other than fares.
Fares at par with public transport: the Metro charges RD$ 20 a trip (EMET/OPRET, 2026) and the Integrated System up to RD$ 35 with transfers (Sistema Integrado de Transporte, 2026); routes to airports and resort areas carry a premium fare. The floors above the megastations are pre-sold, outside the transport investment.
What the country gains
Road safety: Phase I avoids about 6 deaths and about 290 injuries a year on the roads, from the trips that leave the road. For rail there is no official worldwide total of casualties: in the European Union 13,836 people were killed and 10,475 seriously injured in significant rail accidents in 2010–2024 (Eurostat), and in the United States 963 died and 6,535 were injured in 2024 (FRA), mostly people on the tracks and at level crossings.
People who live near a station can do without a car or the daily motorcycle taxi, and the network keeps growing to new cities: imagine what each family saves.
First service: April 2031
A Phase 0 of about 31 months, with system certification completed in Phase 0, before the notice to proceed; notice to proceed around July 2029; first service between October 2030 – October 2031 (P10–P90) and the whole of Phase I around September 2031.
The schedule includes the hurricane season (June to November): under a storm alert no ropes are strung and no work is done at height.
How the investment is protected
Demand
The base case uses 60 % of the traffic-study demand; at 50 %, the equity IRR is 9.7 %. If needed, an availability payment of about US$ 26.2 M a year also reaches 15 %. A traffic study with counts before financial close.Construction cost
P10–P90 range computed over 20,000 sets of prices. At P90 cost and 50 % of the traffic-study demand, the equity IRR is 7.8 %.Hurricanes, earthquakes and floods
Towers and ropes sized for 257 km/h gusts (Dominican wind code, zone I), seismic design to the R-001 code, and towers kept out of river beds. Before a hurricane, the cabins are stored in storm depots. Each line is available 99.93 % of service hours in a typical year.Technology and certification
Carriages and cabins built in series by car makers; system certification is completed in Phase 0, before the notice to proceed.Timing
First service between October 2030 – October 2031 (P10–P90), with the hurricane season already in the schedule.Power
1.5 kV direct-current traction with regenerative braking; the source (grid, own spine or own generation) is chosen section by section. Backup batteries on every tower keep communications and sensors running for 21 days.Transport operators
A transition plan agreed with the unions before the works: compensation for vehicles that leave the road, feeder routes and a share in the business.Counterparty
A concession under Law 47-20, with its rules for award, payments and dispute resolution.The phases that follow
In Santo Domingo, more trips come on as cabin and track capacity grows: demand that Phase II serves.
Phase II · 100.9 km · US$ 1,009 M (P50)
SD1 Los Héroes – Los Alcarrizos (15.8 km); SD2 Ciudad Colonial – Boca Chica (52.4 km); SD5 Ciudad Colonial – San Cristóbal (32.7 km). Phase II (the rest of lines SD1, SD2 and SD5) is financed as its own PPP tranche on Phase I’s operating record; Phase I’s retained cash contributes its equity share.
National network · 2,421 km
1,234 stations, 17 of them megastations, with a total investment of US$ 8,662–10,464 M (P10–P90). Its revenue helps pay for the next stages.
From interest to financial close
- Confidentiality agreement and delivery of the full study and the financial model.
- Memorandum of understanding with the Government and the municipalities; private initiative submitted to the DGAPP under Law 47-20.
- Phase 0: traffic study with counts, surveys, geotechnics, environmental study, PPP structuring and system certification.
- Financial close with the multilateral banks and notice to proceed around July 2029.
- First service around April 2031.
For the technical team
Peak-hour traffic
We reproduced a weekday peak (06:00–08:30) street by street in Greater Santo Domingo, Santiago and Punta Cana – Bávaro, today and with Celestavia.
- Greater Santo Domingo, with the Ciudad Colonial – Los Héroes section: car speeds go from 19.2 to 19.9 km/h (+4 %) and vehicle-kilometres fall by 0.4 %; the line runs full at the peak, with 6,604 passengers an hour each way on its busiest section.
- From Los Alcarrizos (Autopista Duarte) to Av. Winston Churchill at 27 de Febrero, leaving at 06:45: 126 min by car, 130 min by guagua or concho, up to 77 min by motorcycle taxi; with Celestavia, 64 min without booking and 63 min with the app, door to door, by feeder to Los Héroes and then the line.
- Punta Cana – Bávaro: from 38.8 to 45.7 km/h.
- Santiago, as a reference for Phase II: from 19.3 to 25.7 km/h with its urban lines.
Calibration: reference speed of 14 km/h in Greater Santo Domingo, the midpoint of the 11 to 17 km/h averages INTRANT publishes for central corridors.
Phase I packages studied
Of the 9 packages studied, the chosen Phase I has the highest benefit-cost ratio. Every package includes Punta Cana – Bávaro (59.3 km); the last row is the reference of the three whole Santo Domingo lines.
| Package | Km | P50 investment (US$ M) | Trips a day | Equity IRR without support | Availability payment for 15 % (US$ M/yr) | State money / investment | Benefit-cost (10 %) | Method |
|---|---|---|---|---|---|---|---|---|
| SD1 Ciudad Colonial – Los Héroes | 73.1 | 455 | 140,600 | 4.6 % | 26.2 | 46 % | 1.21 | full traffic run |
| SD1 Ciudad Colonial – Plaza de la Bandera | 69.5 | 366 | 72,600 | 6.3 % | 17.1 | 37 % | 1.14 | screening estimate |
| SD2 Ciudad Juan Bosch – Boca Chica | 93.3 | 445 | 54,100 | 3.8 % | 28.7 | 51 % | 0.96 | screening estimate |
| SD1 to Los Héroes + SD2 to Ciudad Juan Bosch | 91.5 | 583 | 182,300 | 2.0 % | 44.8 | 60 % | 1.10 | full traffic run |
| SD1 to Los Héroes + SD2 Ciudad Juan Bosch – Boca Chica | 107.1 | 572 | 99,700 | 1.7 % | 45.5 | 62 % | 0.93 | screening estimate |
| Whole SD1 (Ciudad Colonial – Los Alcarrizos) | 88.9 | 581 | 125,000 | 0.4 % | 50.8 | 69 % | 0.92 | screening estimate |
| Three inner spokes: SD1, SD2 and SD5 | 104.4 | 720 | 168,900 | -1.3 % | 69.9 | 76 % | 0.93 | screening estimate |
| SD1 to Los Héroes + SD2 to Las Américas Airport | 106.2 | 763 | 149,800 | -2.2 % | 77.6 | 145 % | 0.88 | screening estimate |
| Reference: whole SD1, SD2 and SD5 | 174.0 | 1,388 | 249,400 | — | 183.2 | 186 % | 0.70 | screening estimate |
Network, stations and capacity
Populated areas get at least one station per kilometre (1.1 per km in Phase I); rural stretches only where needed: villages, junctions, schools, clinics. A small station can have just two spaces, one for a cabin and one for a waste box, or four; megastations sit at the main nodes and their upper floors are pre-sold.
Phase I carries about 140,600 trips a day at opening (98,700 in Santo Domingo and 41,800 in Punta Cana – Bávaro). At the peak, timetabled platoons run with request stops; the rest of the day, on-demand cabins. With 50 % of trips booked in the app, booked passengers arrive just in time and do not wait; walk-in passengers wait 2.8 minutes or less at the 95th percentile, and 6.1 at the busiest station. Phase I has 861 towers. Carriages run with relative braking under signalling: each follows the one ahead at its own braking distance plus a margin.
Power: 1.5 kV direct current
1.5 kV direct-current traction on every line, with regenerative braking that returns 25 % of the braking energy to the line. In Phase I: a peak of about 30.2 MW, about 89 GWh a year and 19 substations; the base case (a medium-voltage connection at each substation and one hour of batteries) costs US$ 8.3–28.4 million. The source options for the whole network, which further studies will define:
| Option | US$ million (P10–P90) | Note |
|---|---|---|
| Distribution grid at each substation | 53–248 | medium-voltage connection from EDENorte, EDESur or EDEEste; paired with batteries |
| Own 34.5 kV spine on the towers | 157–459 | fed from ETED substations; independent of the distribution companies |
| Own generation | 243–624 | gas, diesel, propane or gasoline sets at megastations and depots; islanded service during blackouts |
| 1-hour batteries at substations | 125–347 | in fireproof containers with their own suppression; ride-through and peak shaving |
Every battery, on carriages, at stations or on towers, sits in a fireproof container with its own fire-suppression system. Battery packs are swappable: at stations a robotic system exchanges a carriage’s pack for a charged one, and every carriage carries enough battery to reach at least the next station.
Hurricanes, earthquakes and floods
Hurricanes
The Dominican Republic lies on the Caribbean hurricane track: David (1979, Category 5, about 2,000 deaths) and Georges (1998, US$ 2,193 million in damage, ECLAC) are the benchmarks. Celestavia towers are designed for 257 km/h gusts (national wind design manual, zone I, with the importance factor), and on a hurricane warning the whole Phase I fleet is stowed within about 8 hours, after the last evacuation runs. With 18 hours of service a day, the network loses about 6 equivalent hours a year: 99.91 % availability.
Earthquakes
The north of the country runs along the Septentrional fault (8-10 mm a year; GEM, 2022), and the 1946 earthquake (magnitude 8.1) raised a tsunami on the north coast. Towers, foundations and stations follow the R-001 seismic code (MOPC, 2011) with each zone’s design acceleration (0.51 g in Santiago and 0.26 g in Santo Domingo for 475 years; GEM TREQ, 2022). Accelerometers along the line stop the carriages within seconds, and service restarts after a camera and drone inspection.
Floods and landslides
On 18 November 2023 more than 431 mm of rain fell in 24 hours on the Distrito Nacional (INDOMET) and the underpasses flooded. Celestavia runs above the streets and keeps running when they flood; no tower stands in a river channel, and towers on flood plains sit on raised pedestals. Stations and substations stand above the 100-year flood and the storm surge.
Operating levels
| Hazard | partial service (L1) | line secured (L2) | rescue and recovery (L3) |
|---|---|---|---|
| Wind (hurricane, tropical storm) full service: gust < 90 km/h | gust 90-136 km/h: no passengers; empty cabins and light boxes at reduced speed | hurricane warning: last evacuation runs before 90 km/h; forecast gusts > 136 km/h, cabins to the shelters; all stowed before 151 km/h | after the storm: tower cameras and drones, rescue carriages on battery, restart section by section |
| Rain and flood full service: < 30 mm/h | 30-60 mm/h or rivers on alert (INDOMET / COE yellow): scour sensors at crossings, low platforms watched | > 60 mm/h or red alert with a flood (Ozama, Isabela, Haina, Yaque del Norte, Yuna): crossing sections slowed or closed until inspected; the elevated line keeps running over flooded streets | after the flood: crossing foundations inspected by drone and sensors |
| Earthquake full service: PGA < 0.05 g | 0.05-0.10 g: automatic stop, restart after a check (~15 min) | 0.10-0.25 g: stop, inspection by cameras and drones (~3 h) | > 0.25 g: suspended, detailed inspection of towers and foundations (2 days; > 0.5 g up to 7 days) |
| Landslides (cordilleras) full service: 72-h rain < 100 mm | 100-200 mm or inclinometers on alert: reduced speed on slope sections | > 200 mm or a movement alarm: section closed | geotechnical inspection, reopening |
| Tsunami (north coast) full service: no alert | information message (PTWC / INDOMET) | warning: low coastal sections evacuated to high stations; cabins out of the inundation zone | inspection once the warning is lifted |
Before a hurricane the Phase I fleet goes down into 10 tie-down yards: each carriage is lowered with its cabin onto a concrete slab and held by four container anchors, more than 8 times stronger than a 324 km/h gust needs. Including 30 years of insurance, this option costs about US$ 39 million in present value, against US$ 79 million for megastation shelters, 123 million for concrete domes and 186 million for underground halls, compared side by side, subject to further study. The whole fleet is stowed in about 4 hours and is back on the line about 5 hours after the storm.
| Fleet protection (10 yards in the base case) | 30-year cost, present value, US$ M (P10–P90) |
|---|---|
| Tie-down yards (slabs with anchors) | 35–44 (P50 39) |
| Shelter floors in megastations | 58–105 (P50 79) |
| Cabins on slabs, carriages in a hall | 85–129 (P50 105) |
| Hardened hall | 82–143 (P50 110) |
| Concrete domes | 90–161 (P50 123) |
| Underground halls | 134–247 (P50 186) |
Monitoring backbone
Fibre and 5G run along every line, with cameras and weather and seismic sensors on the towers. Every tower has batteries for at least 21 days without grid power, so communications, sensors and cameras keep working during and after a storm. The same fibre and antennas are leased to operators, an extra revenue stream.
Transition for transport workers
Drivers and helpers of guaguas, shared taxis, motorcycle taxis and taxis are partners in the change: the plan is agreed with their unions and federations.
- Compensation goes to the vehicles that stop running because their trips move to Celestavia, route by route; the rest keep working, many as feeders to the stations.
- Support paid first from Celestavia’s profits and until each person has work with equal or better income; an income top-up if the new job pays less, and early retirement for those within about 5 years of retirement age. Franchises, shares and feeder routes can be part of the package.
- Buses are not scrapped: newer units are refurbished as motorhomes, feeders, mobile clinics or service for areas with no transport, and Celestavia helps create motorhome parks.
- Support per person or per vehicle is agreed with the unions and the Government.
Methodology
A study on Celestavia’s own initiative, made with public Dominican data; it does not derive from any authority’s plan. The network and stations are laid out on the road map; demand comes from population by zone; capacity is computed with docking windows at each station and a share of booked trips; the cost combines 20,000 sets of unit prices (P10–P50–P90, with the cost per kilometre with and without stations computed in each set); the schedule combines uncertain durations of each activity with the hurricane season; the impact and financial model use the same results. No figure is an offer or a confirmed design value.
Data to be requested later
For now we use public sources only. In Phase 0 we will ask for travel surveys and trip matrices, traffic counts, route registers, passenger numbers data, unit prices and official appraisal parameters from:
- INTRANT
- ayuntamiento de Santiago
- OPRET
- FITRAM
- EMT
- OMSA
- ASONAHORES
- MITUR
- Grupo Puntacana
- Aerodom
- IDAC
- JAC
- MOPC
- Caribe Tours, Metro Tours, Expreso Bávaro, terminal operators
- ONE
- MEPyD
- DGIP
- Catastro Nacional
- ayuntamientos
- DGAPP
- SIE
- ETED
- EDEsur
- EDEnorte
- EDEeste
- Ministerio de Energía y Minas
- INTRANT OPSEVI
- ONAMET
- INDRHI
- COE
- Servicio Geológico Nacional
- CNS-UASD
- Unions
Frequently asked questions
Is it a cable car?
No. The steel ropes are fixed and do not move: each electric carriage drives along them with its own motors, like a vehicle on its track.
What happens in a hurricane?
Before the storm, service is stepped down by levels and the cabins are stored in storm depots; towers and ropes are sized for the design gust. Afterwards, the monitoring backbone, with its 21-day batteries, shows the state of each section so service can resume.
What if the power goes out?
Every carriage carries enough battery to reach at least the next station, and steep stretches have refuge stops.
Does it compete with the Metro and the cable cars?
No: it feeds them. Celestavia covers what only the road covers today: neighbourhoods without service, trips between cities and light cargo.
How much is the fare?
In the city, like public transport and shared taxis (the Metro charges RD$ 20 a trip); routes to airports and resort areas carry a premium fare.
What happens to the drivers?
See Transition: support until equal or better work, refurbished buses and a share in the business.
Videos
How Celestavia works, in five short videos: the cabin, cargo, the small station, the megastation and the health app.
Contact
For investors, infrastructure funds and multilateral banks: write to us to receive the full study and the Phase I financial model.
Do you represent a government, public body or NGO?
Request detailed technical and financial information to assess Celestavia in your region.
Request informationJoin us
Join Celestavia
Public authorities, transport operators, business people and the general public are invited to learn about the proposal, share their ideas and join in. Sign up and we will keep you posted on the project.
